Key Takeaways:

  • EHR cloud migration runs 9 to 18 months for one facility and 18 to 36 months for networks.

  • Discovery, data mapping, interface migration, HIPAA risk assessment, UAT, and stabilization are required phases.

  • Epic, Oracle Health, and Meditech programs stretch when historical data and third-party apps expand scope.

  • HL7 v2 interfaces, revenue cycle workflows, and downtime planning add complexity and extend migration timelines.

  • How Intellivon scopes EHR cloud migrations as phased infrastructure programs, not single cutover events.

If you are scoping a cloud EHR migration, the timeline runs between 12 and 24 months for a community hospital. At the same time, multi-facility health systems should plan for 24 to 36 months. That spread is driven by legacy EHR infrastructure, clinical data volume, and how many third-party interfaces need to migrate alongside it. Getting the scope right from the start is what keeps go-live dates intact and resources properly allocated throughout.

The part that derails EHR migrations comes from treating data conversion, HL7 interface migration, and workflow redesign as parallel workstreams when they are sequential dependencies. Without a dependency sequence built before configuration begins, close to 30% of enterprise EHR migrations overshoot their timeline by 6 months or more. However, health systems that front-load this sequencing recover to baseline productivity 40% faster than those that do not.

Through our experience, we have observed that the approach that keeps migrations on schedule treats data mapping, interface migration, and workflow redesign as a sequenced dependency chain, and not three parallel workstreams. This post covers every phase: realistic timelines, slippage drivers, HIPAA compliance checkpoints, and how to build such a strategy from the ground up.

Migrate To Your New Cloud EHR Platform

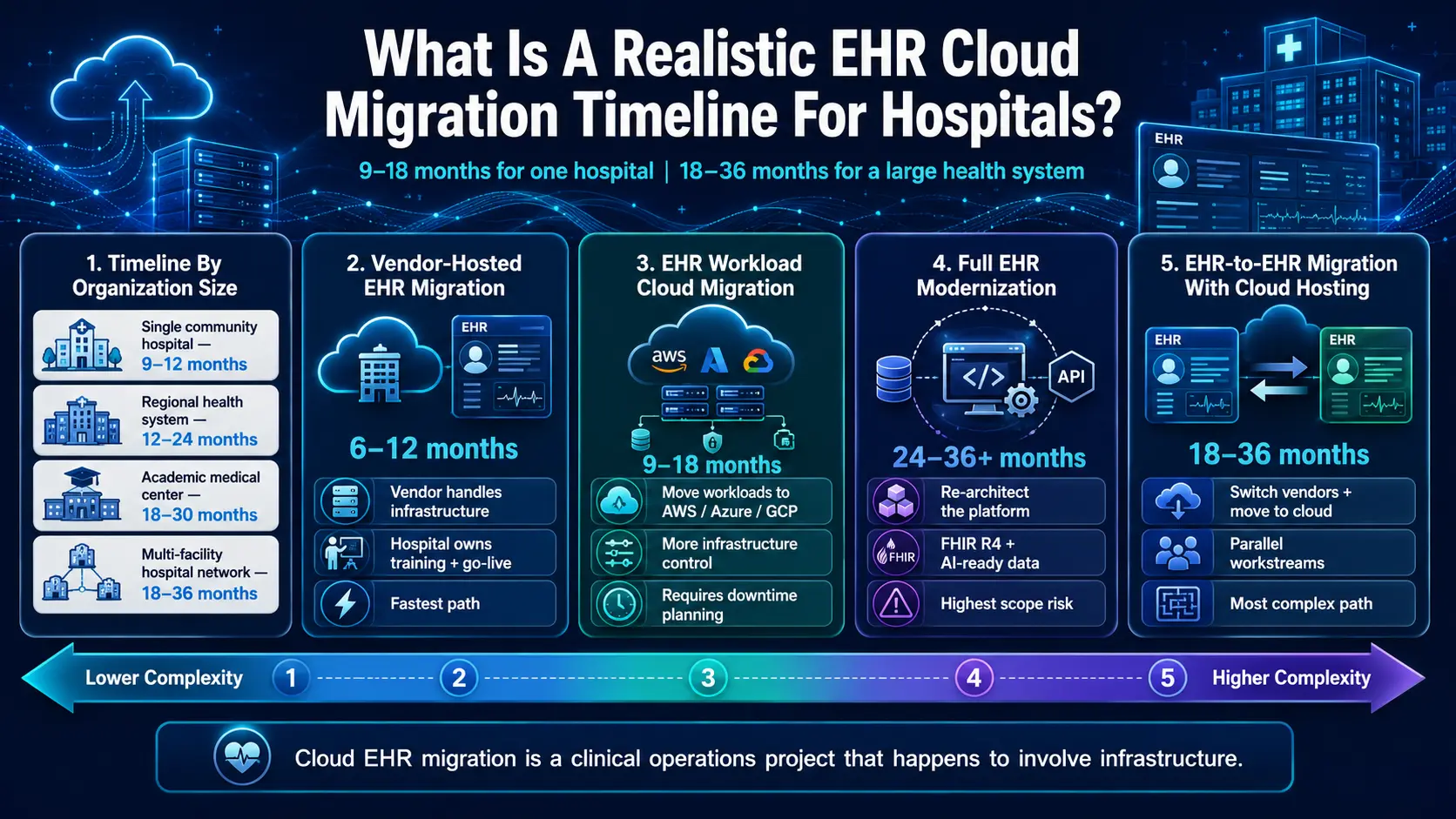

What Is A Realistic EHR Cloud Migration Timeline For Hospitals?

A realistic EHR cloud migration timeline is 9–18 months for one hospital and 18–36 months for a large health system. This timeline includes discovery, assessment, architecture, data migration, integration migration, workflow configuration, testing, training, go-live, and stabilization

At the same time, smaller practices may move faster, but hospitals need controlled sequencing.

What Is A Realistic EHR Cloud Migration Timeline For Hospitals?

1. Timeline By Organization Size

How long cloud EHR migration takes depends almost entirely on your organization’s size and complexity. A community hospital with one facility operates very differently from a network of 15 hospitals, and the timeline reflects that gap directly.

  • Single community hospital — 9–12 months. Fewer interfaces, simpler workflows, and one site to train keep the schedule manageable.
  • Regional health system — 12–24 months. Multiple facilities, more integrations, and larger data volumes require phased planning across departments.
  • Academic medical center — 18–30 months. Teaching programs, research systems, and subspecialty workflows add significant configuration and testing time.
  • Multi-facility hospital network — 18–36 months. The large health system EHR migration timeline stretches here because go-lives must be staggered across facilities to protect patient care continuity.

The cloud infrastructure itself provisions in days. Leaders who present this as a hosting project to their boards almost always return with a revised timeline six months later.

2. Vendor-Hosted EHR Migration

This is the fastest and most common migration path. Your EHR vendor (Epic, Oracle Health, or Meditech) moves your existing system into their managed cloud environment.

  • Typical timeline: 6–12 months
  • What the vendor handles: Infrastructure provisioning, server management, uptime, and backups
  • What you still own: Clinical configuration, interface setup, data validation, training, and go-live management
  • Primary trade-off: You gain speed but give up infrastructure flexibility and direct cloud control

This path works well for hospitals that want to modernize without switching vendors or rebuilding workflows. However, it simply moves them to a new environment. If your current system has messy data or outdated integrations, those problems travel with you

3. EHR Workload Cloud Migration

Here, your existing EHR workloads move from on-premises servers to a public cloud platform, like AWS, Azure, or Google Cloud. This is more complex than vendor hosting.

  • Typical timeline: 9–18 months
  • What changes: Server architecture, storage, networking, and disaster recovery design
  • What stays the same: Your EHR application, clinical configuration, and existing workflows
  • Primary challenge: Your IT team needs cloud architecture expertise — or you need an implementation partner who already has it

This approach gives your organization direct control over infrastructure costs and long-term scalability. However, it requires a clinical downtime plan for the infrastructure cutover, even when the EHR application itself does not change. Skipping that downtime plan is where most hospital EHR cloud migration timelines fall apart.

4. Full EHR Modernization

This is the most ambitious path. It involves rebuilding or significantly re-architecting the EHR platform, and not just moving it. Some organizations use this to adopt modern APIs, FHIR R4 compliance, or AI-ready data architecture.

  • Typical timeline: 24–36+ months
  • What changes: Application architecture, data models, integrations, clinical workflows, and often the vendor
  • Who this is for: Health systems with significant technical debt, outdated legacy systems, or a strategic need for cloud-native infrastructure
  • Primary risk: Scope creep and timeline overrun are highest in this category

Full EHR modernization is a platform rebuild. Organizations that attempt this without a defined governance structure and phased rollout plan typically see timeline overruns of 6–12 months. The EHR modernization timeline must be built with buffer cycles, not assumed best-case delivery.

5. EHR-to-EHR Migration With Cloud Hosting

This is the most complex scenario. You are switching EHR vendors and moving to the cloud at the same time. For an enterprise EHR migration at a large hospital network, this involves parallel workstreams that must be carefully sequenced.

  • Typical timeline: 18–36 months
  • What makes this hard: New vendor configuration, data conversion from the legacy system, interface rebuilding, and staff retraining all happen simultaneously
  • Common example: A health system moving from Cerner to Epic, or from a legacy system to Oracle Health, while adopting cloud hosting at the same time
  • Biggest risk: Clinical disruption during cutover if the go-live sequence is not properly phased across facilities

This path requires the strongest governance structure, the most experienced implementation partner, and the most realistic board expectations of all four migration types. It is also the path where under-scoped programs most commonly stall after month 12.

Cloud EHR migration is a clinical operations project that happens to involve infrastructure. Therefore, the timeline you present to your board must account for data, workflows, interfaces, and people, and not just servers. The next section breaks down exactly why timelines expand and where most programs lose weeks they never recover.

Why Cloud EHR Migration Timelines Expand Beyond The Original Plan

Cloud EHR migration timelines expand when hospitals underestimate data conversion, third-party interfaces, revenue cycle dependencies, reporting migration, workflow redesign, security review, and staff training. These workstreams often run across different departments, so one delayed approval can hold back go-live even when the cloud environment is technically ready.

1. Undocumented Legacy Systems and Poor Current-State Assessment

Most timeline overruns begin before a single line of code moves. When the current-state EHR assessment is incomplete, the team discovers missing documentation mid-project and loses weeks recovering it.

Common issues found during legacy EHR system evaluation:

  • Custom-built modules with no documentation
  • Workflows built around system workarounds that no one recorded
  • Configuration settings changed years ago with no audit trail
  • Clinical decision support rules that no one currently owns
  • Order sets modified by individual departments without central tracking

Discovery that should take 4 weeks often stretches to 10 weeks when the legacy system has been in place for 10 or more years.

2. Interface Ownership Gaps and Undocumented HL7 v2 Feeds

Interface migration is one of the most underestimated workstreams in any EHR cloud migration project. At the same time, most hospitals run 50 to 300 active interfaces, and a large portion of them have no clear owner.

Why this delays timelines:

  • HL7 v2 interface migration often reveals feeds built by vendors no longer under contract
  • Missing documentation forces teams to map interfaces manually, which takes 2 to 4 weeks per interface cluster
  • Integration engine migration, including Mirth Connect migration, requires testing every downstream system separately
  • Third-party vendors frequently have their own change management timelines that do not align with yours
  • API migration for newer systems requires coordination with external development teams

Unclear interface ownership adds 6 to 16 weeks to the integration migration timeline. The fix is a complete interface inventory completed during discovery, with named owners assigned before migration begins.

3. Inconsistent Patient Identifiers and Large Historical Data Scope

Data migration is rarely a clean lift. At the same time, most hospitals carry years of inconsistent patient records, duplicate medical record numbers, and mismatched identifiers across systems.

The most common data quality problems include:

  • Duplicate patient records created during previous system upgrades
  • Inconsistent date formats across clinical and billing systems
  • Missing or incomplete demographic fields required by the new system
  • HL7 CDA migration failures caused by non-standard document structures
  • Historical data migration EHR scope that grows once the team starts auditing records

Poor data quality adds 4 to 12 weeks to the data migration timeline. Additionally, hospitals often decide mid-project to migrate more historical records than originally scoped. Each expansion resets the data validation timeline. Clinical data migration timelines must lock scope early and enforce a change control process to prevent this. (Source: Deloitte, 2026)

4. Revenue Cycle and Reporting Migration Dependencies

Revenue cycle migration is frequently the workstream that delays final go-live approval. At the same time, it sits downstream of clinical configuration, so problems elsewhere compound here.

Why revenue cycle delays are so common:

  • Charge description master migration requires sign-off from clinical, billing, and compliance teams
  • Coding system migration must align with current payer contracts and fee schedules
  • Claims system migration testing depends on completed interface testing from the prior phase
  • Reporting migration EHR dependencies require a functioning data warehouse before analytics can be rebuilt
  • Population health tool migration and quality reporting migration often run on separate tracks with separate vendor timelines

Revenue cycle complexity adds 8 to 20 weeks to the overall EHR cloud migration project timeline. This is the highest-impact delay category and the one most often underestimated in initial project plans.

5. Physician Sign-Off Delays and UAT Bottlenecks

User acceptance testing is where clinical reality meets the project plan. Physicians, nurses, and revenue cycle staff must validate that the system works for their actual workflows before go-live approval is granted.

Common UAT timeline blockers:

  • Physicians are unavailable during scheduled testing windows
  • Clinical scenarios identified in UAT require configuration changes that restart testing cycles
  • Nursing and physician training timelines and EHR sign-off require completed, stable configuration first
  • Super user training cannot begin until the UAT environment is locked
  • At-the-elbow support planning cannot be finalized until training completion rates are confirmed

UAT testing timeline bottlenecks add 4 to 10 weeks when physician scheduling, configuration changes, and training dependencies are not planned in advance.

At the same time, the go-live planning timeline must treat UAT as a gate, not a formality. Skipping retest cycles to hit a deadline is one of the most common causes of post-go-live instability.

6. “Technically Complete” Is Not The Same As “Operationally Ready”

This distinction causes more timeline surprises than any single technical problem. At the same time, a hospital can have a fully provisioned cloud environment, completed data migration, and configured workflows and still not be ready to go live.

Operational readiness requires:

  • Completed and signed-off physician training
  • Confirmed downtime contingency planning and printed downtime procedures
  • Approved go-live support staffing and at-the-elbow coverage schedule
  • Revenue cycle team sign-off on billing workflows
  • Final HIPAA risk assessment and BAA requirements migration vendor confirmations
  • Completed disaster recovery migration testing and business continuity planning sign-off

Teams that declare “technical migration complete” before operational readiness is confirmed almost always face a delayed go-live. The cloud environment being ready does not mean the hospital is ready. Both must be true at the same time.

7. Cloud EHR Migration Timeline Risk Summary

Timeline Risk Where It Appears Timeline Impact
Poor data quality Data migration Adds 4 to 12 weeks
Undocumented interfaces Integration migration Adds 6 to 16 weeks
Revenue cycle complexity Billing and claims testing Adds 8 to 20 weeks
Clinical sign-off delays UAT and go-live approval Adds 4 to 10 weeks
Training gaps Go-live support Adds 2 to 8 weeks
Downtime plan gaps Cutover planning Adds 2 to 6 weeks

Any one of these risks can delay your go-live. Two or more appearing together is what turns an 18-month project into a 26-month one.

Timeline overruns come from dependency work, not from cloud setup. The cloud environment is rarely the bottleneck. Data quality, interface ownership, revenue cycle testing, and physician sign-off are.

Therefore, the migration plan must include formal approval gates, named owners for every workstream, and realistic buffer time built in from the start. The next section maps out the actual cloud EHR migration phases timeline, phase by phase.

Migrate To Your New Cloud EHR Platform

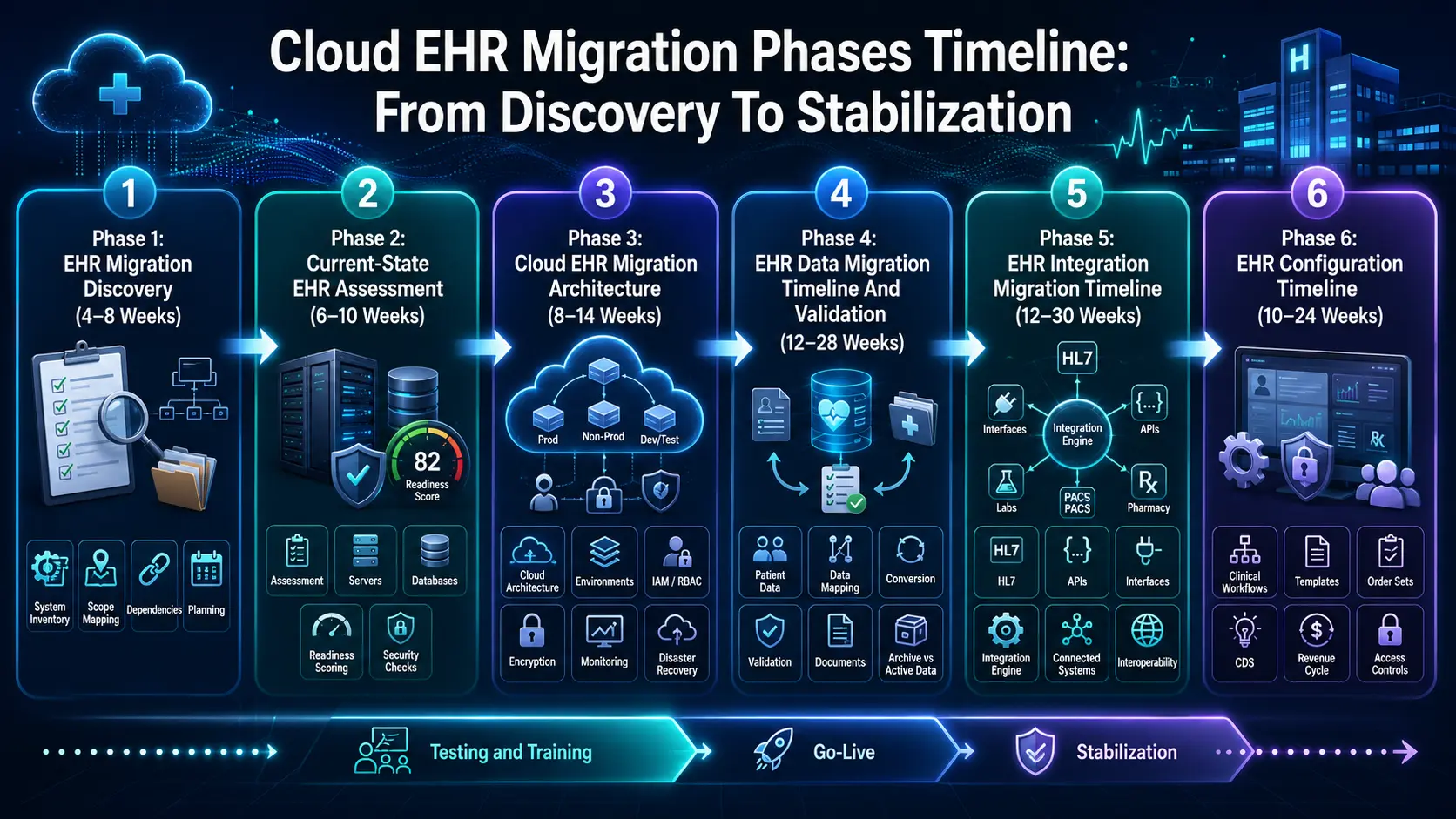

Cloud EHR Migration Phases Timeline: From Discovery To Stabilization

Cloud EHR migration phases timeline planning should follow eight core phases: discovery, current-state assessment, cloud architecture, data migration, integration migration, workflow configuration, testing and training, go-live, and stabilization.

These phases overlap, but each one needs defined owners, acceptance criteria, compliance checks, and rollback planning before the next phase begins.

Cloud EHR Migration Phases Timeline: From Discovery To Stabilization

Phase 1: EHR Migration Discovery (4–8 Weeks)

The EHR migration discovery timeline usually takes 4–8 weeks for one hospital and 8–12 weeks for a multi-facility network. This phase defines migration scope, business goals, system dependencies, user groups, compliance requirements, vendor access, rollout strategy, and board-level expectations before any technical work begins.

What this phase involves technically:

  • Inventory EHR modules, hosting model, databases, storage, and application dependencies
  • List clinical systems, billing tools, claims systems, patient portals, analytics platforms, and population health tools
  • Map Epic, Oracle Health, Meditech Expanse, athenahealth, or custom EHR dependencies
  • Document HL7 v2 feeds, CDA documents, FHIR R4 APIs, X12 claims, SSO, VPN, and reporting dependencies
  • Decide whether the first wave includes production workloads, read-only archives, disaster recovery, analytics, or non-clinical workloads

Intellivon starts with current-state EHR assessment and dependency mapping. The team separates infrastructure work from clinical, operational, revenue-cycle, and compliance work so program leaders can see the real cloud EHR migration project timeline from day one.

Once the discovery map is complete, the next step is deciding what should move, retire, archive, or stay on-premises temporarily.

Phase 2: Current-State EHR Assessment (6–10 Weeks)

The EHR migration assessment phase usually takes 6–10 weeks because hospitals must evaluate legacy infrastructure, data quality, interface stability, workflow ownership, security controls, downtime processes, reporting needs, and business continuity gaps.

This phase decides whether the migration should be rehosting, replatforming, refactoring, or staged modernization.

What this phase involves technically:

  • Review servers, databases, storage, operating systems, backup, disaster recovery, and failover design
  • Identify legacy EHR system evaluation gaps, including undocumented modules and unsupported applications
  • Assess old applications that depend on EHR data for day-to-day operations
  • Review data retention policies and archive requirements for clinical and billing records
  • Check encryption, access control, audit logs, and PHI security migration readiness
  • Score every system as migrate, retain, retire, replace, or archive

Intellivon builds a migration readiness scorecard across infrastructure, data, interfaces, compliance, workflow, and operational risk. This gives CIOs and CMIOs a cleaner way to explain project scope and sequencing to leadership without technical jargon.

After the assessment, the hospital can design the target cloud EHR migration architecture with confidence.

Phase 3: Cloud EHR Migration Architecture (8–14 Weeks)

Cloud EHR migration architecture usually takes 8–14 weeks to design, validate, and provision.

This phase covers landing zones, network segmentation, identity management, encryption, backup, disaster recovery, logging, monitoring, environment separation, and cloud infrastructure provisioning timeline work across AWS, Azure, Google Cloud, or Oracle Cloud.

What this phase involves technically:

  • Design dev, test, staging, training, disaster recovery, and production environments separately
  • Configure IAM, RBAC, MFA, VPN, private connectivity, and key management
  • Build encryption for data at rest and in transit across all environments
  • Set up observability, audit logs, alerts, and cloud cost monitoring dashboards
  • Define disaster recovery migration timeline requirements and recovery time objectives
  • Build downtime contingency planning and business continuity planning EHR controls for the go-live period

Intellivon designs cloud architecture around patient-care continuity, compliance, and future integration needs. The goal is not only to host the EHR but to create a secure operating foundation for data exchange and long-term modernization.

Once the cloud foundation is ready, the highest-risk workstream begins: clinical data migration.

Phase 4: EHR Data Migration Timeline And Validation (12–28 Weeks)

The EHR data migration timeline usually takes 12–28 weeks because hospitals must extract, map, cleanse, convert, validate, and reconcile patient data. Clinical data migration timeline work expands when historical data includes medications, allergies, immunizations, lab results, imaging references, notes, orders, claims, scanned documents, and billing history.

What this phase involves technically:

  • Define what data moves into the active EHR and what moves into a compliant archive
  • Map demographics, encounters, problems, allergies, medications, immunizations, procedures, labs, radiology, clinical notes, and billing records
  • Run data mapping EHR migration workshops with clinical and billing subject-matter experts
  • Clean duplicate, incomplete, outdated, and inconsistent records before conversion
  • Validate patient record migration timeline accuracy with clinical SMEs at each milestone
  • Convert HL7 CDA migration files where legacy document structures do not match the target system
  • Decide how clinical document migration and scanned-document access will work post go-live

Intellivon separates go-forward clinical data from legal-retention archive data. This prevents hospitals from loading the new environment with low-value historical data while still preserving access for care continuity and compliance audits.

After data migration planning, the hospital must rebuild and validate the entire interface ecosystem.

Phase 5: EHR Integration Migration Timeline (12–30 Weeks)

EHR integration migration timeline planning usually takes 12–30 weeks because every third-party integration must be rebuilt, secured, routed, tested, and monitored.

HL7 v2 interface migration, API migration, EHR work, integration engine migration, and FHIR R4 migration timeline tasks often control the real go-live date more than any other workstream.

What this phase involves technically:

  • Rebuild lab, pharmacy, radiology, imaging, scheduling, billing, claims, coding, HIE, remote patient monitoring, telehealth, patient portal, and analytics interfaces
  • Validate ADT, ORM, ORU, SIU, DFT, and billing messages across every connected system
  • Complete Mirth Connect migration timeline work where applicable, including message routing and transformation rules

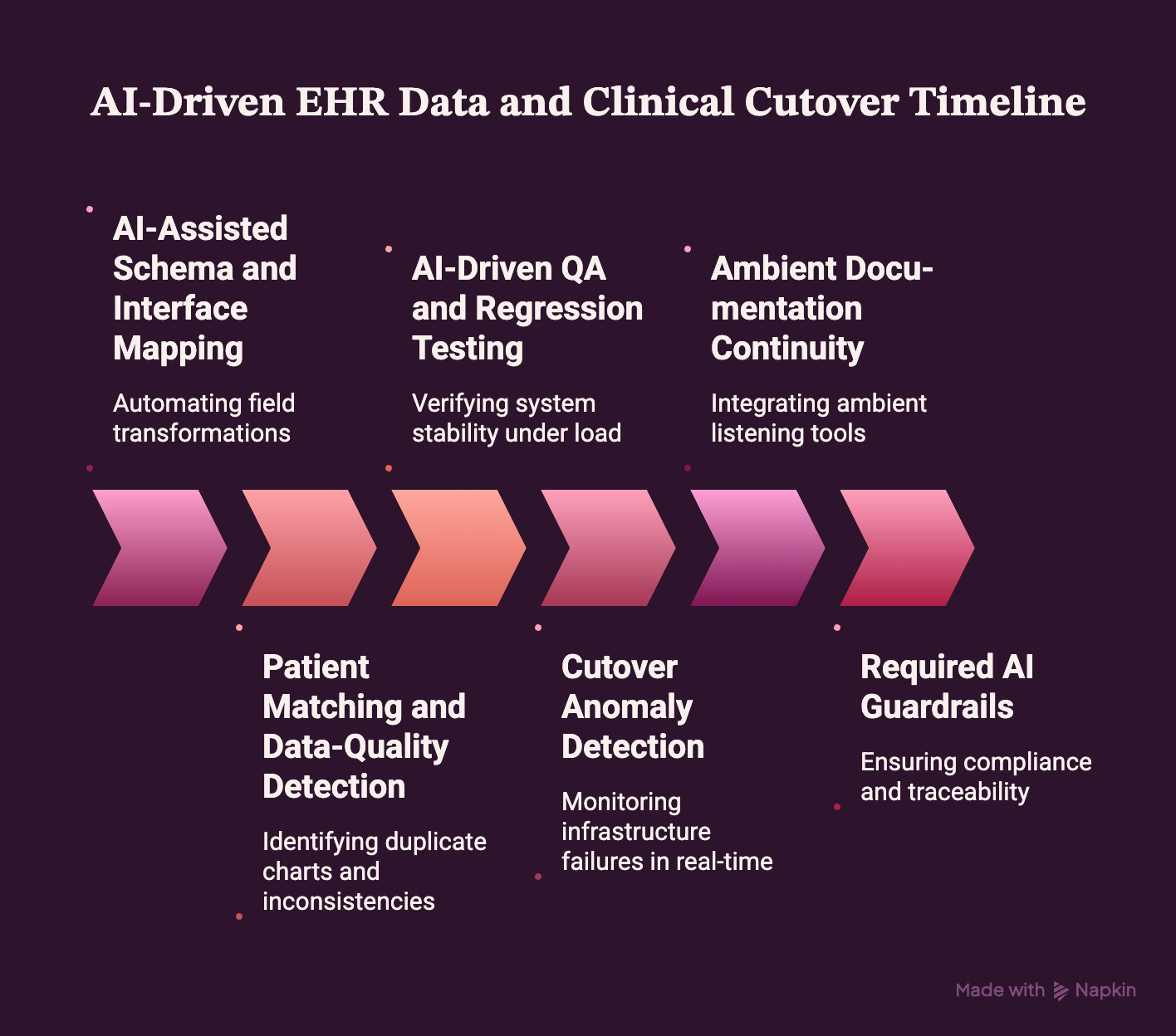

  • Route messages through Mirth, Rhapsody, Cloverleaf, InterSystems, or the integration engine in scope
  • Configure FHIR R4 APIs for patient access, scheduling, claims, observations, and interoperability workflows
  • Validate patient access API compliance and CMS interoperability compliance timeline requirements before go-live

Intellivon avoids rebuilding every interface as a standalone connection. The team designs reusable integration layers that support facility-by-facility migration timeline work and later interoperability expansion without rebuilding from scratch.

For a deeper breakdown of enterprise integration economics, see our guide on How Much Does A 50+ Hospital EHR Integration Platform Cost?

Once integrations are stable, the project must align clinical workflows, templates, and revenue operations before testing begins.

Phase 6: EHR Configuration Timeline (10–24 Weeks)

EHR configuration timeline work usually takes 10–24 weeks because hospitals must configure clinical workflows, forms, order sets, templates, formulary rules, clinical decision support, charge capture, coding logic, billing workflows, reporting outputs, and role-based access.

Workflow configuration must finish before UAT begins, not during go-live pressure.

What this phase involves technically:

  • Configure physician, nursing, pharmacy, lab, radiology, ED, ICU, ambulatory, surgical, and inpatient workflows
  • Complete order set migration timeline requirements with clinical governance sign-off at each specialty
  • Configure clinical decision support migration rules and validate alert logic with clinical champions
  • Rebuild formulary migration timeline workflows and validate against current pharmacy contracts
  • Validate charge description master migration and CDM migration timeline completeness with revenue cycle leads
  • Configure revenue cycle migration timeline requirements, including billing system migration, EHR and coding system migration logic
  • Confirm role-based access controls align with HIPAA compliance migration timeline requirements

Intellivon maps each workflow to its corresponding configuration, interface, data, testing, and training tasks. This traceability helps leaders see how one workflow change affects the broader migration schedule before it becomes a go-live problem.

After configuration, the hidden timeline layer becomes visible: billing, claims, reporting, and cutover readiness all converge in the final phases.

The Hidden Timeline Layer: Revenue Cycle, Reporting, And Interface Cutover

The hidden delay in cloud EHR migration often comes from revenue cycle, reporting, and interface cutover rather than cloud setup. Hospitals must validate claims, coding, charge capture, payer files, dashboards, analytics feeds, and third-party systems before go-live. If planned late, these workstreams alone can add 8 to 20 weeks.

Before cutover, these dashboards must be validated and confirmed working: daily census, ED throughput, OR utilization, discharge reports, quality reporting, revenue reports, claims status, denial rates, and productivity dashboards.

Hidden Layer

Cutover Workstream What Must Be Validated Timeline Risk
Charge capture CDM, modifiers, department charges Missed revenue
Claims X12, clearinghouse, payer routing Claim delays
Coding ICD-10, CPT, HCC, documentation rules Coding rework
Reporting Operational and financial dashboards Leadership blind spots
Analytics Data warehouse feeds and quality checks Broken KPIs
Interfaces HL7, FHIR, APIs, file drops Workflow disruption

Intellivon treats revenue cycle, reporting, and interface cutover as first-class workstreams. As a result, the team builds validation checkpoints before go-live so finance, clinical operations, and IT do not discover billing or reporting defects after claims start moving.

A hospital can technically complete its EHR cloud migration and still break billing or reporting. Therefore, revenue cycle and analytics validation must sit inside the main project timeline, not beside it. The next section covers testing and training, where go-live readiness is formally confirmed.

Phase 7: EHR Testing Timeline, UAT, And Parallel Run (8–16 Weeks)

The EHR testing timeline usually takes 8 to 16 weeks. It must cover unit testing, interface testing, data validation, security testing, UAT, downtime drills, regression testing, and parallel run checks. Because this phase catches defects before they reach patients and billing teams, it should never be compressed to meet a deadline.

What this phase involves technically:

  • Test patient lookup, documentation, orders, results, medication workflows, scheduling, billing, claims, and reporting
  • Run specialty-specific UAT sessions by department so each team validates their own workflows
  • Validate interface messages under real-world volume, not just sample data
  • Run downtime planning drills with clinical and nursing staff before cutover
  • Validate access roles, audit logs, and all HIPAA compliance controls
  • Complete parallel run checks for every high-risk clinical and billing workflow

Intellivon builds test matrices by department, workflow, interface, data object, compliance control, and user role. As a result, CIOs, CMIOs, and program leads get a clear, department-by-department readiness picture before anyone approves a go-live date.

After testing confirms the system works correctly, the hospital must prepare every user for changed workflows before cutover begins.

Phase 8: Training and Go-Live (6–12 Weeks Training)

Training timeline: EHR migration work usually takes 6 to 12 weeks before cutover. After that, go-live support should cover 2 to 6 weeks of intensive at-the-elbow coverage.

Then, post-go-live stabilization typically runs 60 to 120 days, specifically for physicians, nurses, coders, billers, and super users adjusting to new workflows.

What this phase involves technically:

  • Build physician training plans by specialty and role, not just by system function
  • Build nursing training plans with unit-specific workflow walkthroughs
  • Train super users first so they can support their teams during and after go-live
  • Choose a phased go-live timeline, big bang migration timeline, or hybrid rollout based on your organization’s risk tolerance
  • Plan at-the-elbow support hours, command center staffing, and issue escalation protocols in advance
  • Define rollback triggers, triage processes, and stabilization KPIs before cutover begins, not after

Intellivon connects training and go-live planning directly to production support dashboards. Throughout stabilization, the team tracks ticket volume, unresolved issues, interface errors, claim holds, and clinician workflow friction so problems get resolved before they compound.

How Much Does EHR Cloud Migration Cost By Phase?

A hospital EHR cloud migration usually costs $50,000 to $250,000 for custom engineering, cloud architecture, data migration, integrations, compliance, testing, training support, go-live, and stabilization, excluding EHR licensing. Larger multi-hospital programs can exceed this range when data, revenue cycle, interfaces, and rollout complexity expand scope significantly.

Most program leads receive a single IT budget estimate. However, that approach hides which workstreams are actually driving cost. Instead, breaking the budget down by phase gives boards, finance teams, and implementation partners a much clearer picture of where money goes and why.

The table below shows typical cost ranges by phase, along with the specific factors that push each one higher.

Development Cost Phase-Wise

Development Phase Typical Cost Range What Drives Cost Up
Discovery and current-state assessment $4,000 to $15,000 Multiple facilities, undocumented systems, unclear ownership
Cloud architecture and infrastructure provisioning $6,000 to $25,000 Multi-region DR, zero trust, complex identity, high availability
Data migration and validation $8,000 to $40,000 Historical data, scanned documents, custom schemas, archive design
Integration migration $10,000 to $50,000 HL7 v2, FHIR APIs, Mirth Connect, billing interfaces, imaging
Workflow configuration $6,000 to $28,000 Specialty workflows, order sets, CDM, formulary, RCM logic
Revenue cycle and reporting cutover $5,000 to $22,000 Claims, coding, dashboards, analytics feeds, payer files
Compliance and security controls $4,000 to $15,000 HIPAA, SOC 2, HITRUST, audit logs, vendor risk review
Testing, UAT, and parallel run $5,000 to $20,000 Department count, test cases, volume testing, reporting validation
Training and go-live support $6,000 to $28,000 Staff size, super users, at-the-elbow support, phased rollout
Stabilization and optimization $4,000 to $15,000 Ticket volume, workflow defects, reporting fixes, interface tuning



Ongoing Maintenance

After go-live, ongoing maintenance typically costs 15% to 25% of the initial build per year. This covers monitoring, interface updates, cloud cost optimization, security reviews, audit evidence, reporting fixes, compliance updates, and post-go-live workflow improvements. Because healthcare systems change regularly, maintenance is not a future consideration. It is an ongoing cost that starts the day stabilization ends.

Cost rises when the migration touches old data, live interfaces, claims, reporting, and multi-facility rollout waves. Therefore, the budget must be broken down by workstream and presented that way to boards and finance teams. A single blended IT estimate almost always leads to mid-project reforecasting. The next section covers the architecture decisions that shape everything above.

What Architecture Supports A Faster Cloud EHR Migration Timeline?

A faster EHR cloud migration timeline requires modular cloud architecture with secure landing zones, identity controls, integration middleware, normalized data services, backup, disaster recovery, observability, audit logging, and automated deployment. Hospitals should avoid copying every legacy dependency into the cloud because that preserves old risk and cost.

Architecture decisions made in weeks two through six shape every phase that follows. Therefore, the design must account for data validation speed, interface performance, downtime duration, security review scope, disaster recovery testing, and future modernization capacity before a single workload moves.

1. Cloud Landing Zone And Network Foundation

The cloud landing zone is the first layer built and the one every other layer depends on. A poorly designed landing zone forces rework during data migration, integration, and compliance review.

What a production-ready landing zone includes:

  • Separate environments for development, testing, staging, training, disaster recovery, and production
  • Private connectivity between on-premises EHR systems and the cloud during migration transition
  • Network segmentation that isolates clinical workloads from billing, analytics, and non-clinical systems
  • Firewall rules, VPN configuration, and egress controls aligned with PHI security migration requirements
  • AWS Healthcare cloud, Azure Health Data Services, Google Cloud Healthcare, or Oracle Cloud Infrastructure provisioned based on EHR vendor certification requirements

The landing zone should also define cloud cost monitoring from the start. Otherwise, cloud spend escalates quickly during data migration and testing phases, specifically when teams run parallel environments simultaneously.

2. Identity, Access, And EHR Application Hosting

Identity and access controls decide who can reach what data, when, and from which device. For EHR migration, these controls must align with HIPAA, HITRUST, and SOC 2 requirements before any clinical data moves.

What this layer covers:

  • Role-based access control mapped to clinical, billing, admin, and IT user groups
  • Multi-factor authentication for all clinical and privileged access accounts
  • Single sign-on integration with the hospital’s existing identity provider
  • Key management and encryption for data at rest and in transit
  • Privileged access management for database administrators and migration engineers
  • EHR application hosting configuration validated against vendor cloud deployment requirements

When identity controls are set up correctly early, security reviews in later phases move faster. When they are retrofitted during compliance review, they typically add 4 to 8 weeks to the overall timeline.

3. Data Migration Pipeline And Integration Engine

The data migration pipeline and integration engine together control how fast and how cleanly data moves from the legacy system to the new cloud environment. Both must be designed before migration begins, not built alongside it.

What this layer includes:

  • Extraction pipelines for demographics, encounters, clinical notes, orders, results, billing records, and scanned documents
  • Data transformation logic for schema differences between legacy and target EHR systems
  • Data cleansing and deduplication workflows for patient identifier normalization
  • Integration engine configuration, including Mirth Connect, Rhapsody, Cloverleaf, or InterSystems
  • HL7 v2 interface migration routing and FHIR R4 API configuration for interoperability
  • Message validation, error handling, and retry logic for every connected system

Without a purpose-built pipeline, data migration becomes a manual process. Manual processes introduce errors, slow validation, and add weeks to each migration wave.

4. API Management, Reporting, And Analytics Layer

Modern cloud EHR architecture includes an API management layer that controls how systems exchange data externally. Additionally, this layer supports the reporting and analytics infrastructure that leadership depends on during and after migration.

What this layer includes:

  • FHIR R4 APIs for patient access, scheduling, clinical data exchange, and claims
  • CMS interoperability compliance and ONC HTI-1 compliance configurations
  • Patient access API compliance controls for third-party application access
  • Data warehouse migration EHR feeds rebuilt on cloud-native pipelines
  • Operational dashboard connectivity for daily census, ED throughput, OR utilization, and revenue reports
  • Population health migration timeline feeds and quality reporting migration outputs

Analytics migration timeline work should run in parallel with data migration, not after it. When reporting infrastructure is built late, leadership operates without visibility during stabilization, which is exactly when they need it most.

5. Security, Compliance, And Observability

Security and compliance controls are not a final checklist. Instead, they are architecture decisions that affect every other layer. When built correctly from the start, HIPAA risk assessment, SOC 2 compliance, and HITRUST migration reviews move faster and cost less.

What this layer includes:

  • Audit logging for all PHI access, configuration changes, and administrative actions
  • Encryption key rotation policies and data classification rules across all environments
  • HIPAA BAA requirements migration vendor confirmations for every cloud service in scope
  • Monitoring dashboards for infrastructure health, interface performance, and security events
  • Disaster recovery migration timeline testing with defined recovery time and recovery point objectives
  • Business continuity planning EHR controls validated and drilled before cutover begins

Intellivon designs cloud EHR migration architecture around production operations. This includes PHI controls, audit logs, interface observability, rollback paths, downtime procedures, and cost visibility from day one of architecture design.

For a deeper breakdown of AI-ready EHR architecture, see our guide on Building Smart EHR Systems with AI Capabilities.

Architecture quality decides whether cloud migration becomes a safer operating foundation or simply a hosting change. Therefore, cloud design must support resilience, interoperability, analytics, and compliance from the very beginning. The next section covers the compliance requirements that run through every phase of the migration timeline.

Migrate To Your New Cloud EHR Platform

What Compliance Work Must Fit Into The EHR Cloud Migration Timeline?

HIPAA compliance migration timeline work should start during discovery and continue through stabilization. Hospitals must plan PHI security migration, HIPAA risk assessment, BAA review, access controls, encryption, audit logging, disaster recovery, CMS interoperability compliance timeline requirements, ONC HTI-1 compliance, information blocking compliance, and patient access API compliance.

Compliance is not a phase that happens after technical work finishes. Instead, it runs alongside every phase from day one. Teams that treat compliance as a final checklist consistently face delayed go-live approvals, rework cycles, and vendor contract gaps that add weeks to the timeline.

1. HIPAA Security Rule: Administrative, Physical, And Technical Safeguards

The HIPAA Security Rule organizes compliance requirements into three safeguard categories. Each one must be addressed during architecture, configuration, and testing, not reviewed for the first time during go-live approval.

Administrative safeguards cover:

  • Assigned security responsibility and workforce training
  • Risk analysis and ongoing risk management processes
  • Contingency planning, including disaster recovery and business continuity controls
  • Access management policies for all staff who touch PHI during or after migration

Physical safeguards cover:

  • Workstation controls for any device accessing the cloud EHR environment
  • Device and media disposal procedures for decommissioned on-premises hardware
  • Facility access controls for server rooms and data center locations used during transition

Technical safeguards cover:

  • Unique user identification and automatic logoff for all EHR sessions
  • Audit controls that log every user action, data access event, and administrative change
  • Transmission security including encryption for all PHI moving between systems
  • Access controls including RBAC, MFA, and break-glass workflows for emergency access

When all three safeguard categories are mapped to architecture decisions early, the HIPAA risk assessment timeline moves significantly faster during the testing phase.

2. BAA Requirements And Vendor Risk Review

Every vendor that touches PHI during migration must sign a Business Associate Agreement before work begins. This requirement applies to cloud providers, integration partners, implementation firms, and support vendors.

What BAA review covers:

  • Cloud infrastructure vendors, including AWS, Azure, Google Cloud, and Oracle Cloud
  • Integration engine vendors and middleware providers handling HL7 or FHIR traffic
  • Data migration tool vendors processing patient records during extraction and conversion
  • Implementation partners and at-the-elbow support firms with system access
  • Analytics and reporting vendors receiving data warehouse feeds post-migration

BAA review should happen during vendor selection, not after contracts are signed. Additionally, each BAA must address subcontractor obligations so that third-party tools used by vendors are also covered. Missing a single BAA creates a compliance gap that delays go-live approval.

3. SOC 2 And HITRUST For Enterprise Programs

For larger health systems, SOC 2 compliance migration timeline and HITRUST migration timeline work go beyond HIPAA requirements. Both frameworks validate that security controls are operating consistently, not just documented.

SOC 2 compliance covers:

  • Security, availability, processing integrity, confidentiality, and privacy trust service criteria
  • Third-party auditor review of cloud infrastructure controls and access management
  • Evidence collection across logging, monitoring, change management, and incident response

HITRUST covers:

  • A prescriptive control framework mapped to HIPAA, NIST, ISO, and CMS requirements
  • Validated assessment against 19 control categories including access control, audit logging, and risk management
  • Third-party validated certification that many payers and health systems require before data exchange begins

Both frameworks require evidence collected during development and testing. Therefore, teams that build compliance evidence as they go complete SOC 2 and HITRUST reviews faster than teams that reconstruct evidence after deployment.

3. CMS Interoperability, ONC HTI-1, And Information Blocking

CMS interoperability compliance timeline requirements and ONC HTI-1 compliance obligations must be validated before go-live, specifically for any hospital exchanging patient data through APIs or third-party applications.

What this compliance area covers:

  • Patient access API compliance requiring FHIR R4 endpoints for patient data access
  • Provider directory API requirements for health systems participating in payer exchange
  • Information blocking compliance timeline obligations under the 21st Century Cures Act
  • ONC HTI-1 compliance covering conditions and maintenance of certification for certified EHR technology
  • Electronic health information access, exchange, and use rules that prohibit practices that limit data sharing

Information blocking compliance is frequently overlooked during EHR migration scoping. However, switching EHR platforms or moving to cloud hosting can inadvertently create information blocking situations if patient data access is interrupted or restricted during transition. Workflow and policy review must specifically address this before cutover.

Why Compliance Cannot Sit At The End Of The Project

Treating compliance as a final review creates three specific problems. First, architectural decisions that require rework are expensive to change after build.

Second, vendor contract gaps discovered late require legal review cycles that delay project timelines. Third, audit logging and access control gaps found during go-live approval require configuration changes that restart testing.

Compliance evidence collected during development includes:

  • Architecture diagrams showing PHI data flows, encryption points, and access boundaries
  • Audit log samples from testing environments validating user action tracking
  • Penetration test results and vulnerability scan outputs from security review
  • Completed risk analysis documentation covering all new cloud systems and vendors
  • Training records confirming workforce completion of HIPAA and security awareness training

When compliance is built into each phase, go-live approval becomes a confirmation, not a discovery process.

Compliance Timeline By Area

The table below maps each compliance area to the correct project phase, so teams know when each control must be validated rather than discovering gaps during go-live review.

Compliance Timeline Table

Compliance Area Best Timeline Placement What To Validate
HIPAA risk assessment Discovery and architecture PHI flow, access, storage, transmission
BAA review Vendor selection Cloud, integration, support, data vendors
Encryption Architecture At rest, in transit, key management
Audit logging Architecture and testing User actions, data movement, admin events
Access controls Configuration and UAT RBAC, MFA, break-glass workflows
Disaster recovery Testing RTO, RPO, failover, downtime plan
Patient access API Integration testing FHIR resources, authentication, release rules
Information blocking Workflow and policy review Access, exchange, and use of EHI

Intellivon builds compliance evidence during development, not after deployment. As a result, the team maps controls to architecture decisions, data movement, integration traffic, audit logs, user roles, and go-live approval criteria from the start of the project.

For a deeper breakdown of healthcare security architecture, see our guide on How to Make Security Architecture for HIPAA-Ready Health Platforms.

Compliance shapes architecture, data migration, integrations, vendor contracts, testing, and go-live readiness. Therefore, it must be treated as a continuous workstream, not a final gate. The next section explains how timeline and cost differ across the major EHR vendors.

Epic, Oracle Health, Meditech, And Athenahealth: How Timelines Differ

Epic cloud migration timeline planning differs from Oracle Health cloud migration timeline, Meditech Expanse migration timeline, and athenahealth migration timeline work because each vendor has different hosting models, data structures, APIs, reporting environments, integration pathways, upgrade cycles, and implementation partner requirements. Hospitals should not reuse one vendor’s timeline across another vendor.

Each EHR platform carries its own technical dependencies, and those dependencies directly affect how long discovery, configuration, integration, testing, and go-live take. Therefore, the timeline must be built around the specific vendor in scope, not a generic EHR migration framework.

1. Epic Cloud Migration Timeline

Epic implementation timeline work is typically the most structured of all major vendors, but also one of the most resource-intensive. At Epic controls its hosting model tightly, and its reporting, integration, and upgrade dependencies require dedicated analyst capacity throughout the project.

Key timeline factors for Epic:

  • Epic operates through its own hosting model, which means cloud workload migration follows Epic’s internal provisioning schedule, not the hospital’s preferred cloud timeline
  • Clarity and Caboodle reporting environments require separate build, validation, and cutover planning that runs parallel to clinical configuration
  • Interconnect, Bridges, MyChart, and downstream integrations each carry their own testing requirements and analyst ownership
  • Epic go-live timeline work requires certified Epic analysts, and analyst capacity is frequently a bottleneck for mid-market hospitals without deep internal teams
  • Epic’s upgrade cycles must be factored into the migration schedule because a major upgrade landing mid-migration resets configuration and testing work

Additionally, Epic requires formal go-live readiness reviews before approving cutover. Hospitals that understaff their Epic analyst team consistently see 3 to 6 month timeline extensions during configuration and UAT.

2. Oracle Health Cloud Migration Timeline

Oracle Health Cloud migration timeline planning, specifically for Oracle Cerner cloud migration, involves moving Millennium workflows to Oracle Cloud Infrastructure.

This is a technically distinct path from Epic because Oracle Health controls the underlying OCI environment differently.

Key timeline factors for Oracle Health:

  • Oracle Health Foundation EHR dependencies must be mapped before OCI readiness can be confirmed
  • Millennium workflow configuration carries its own specialty-by-specialty build schedule that does not compress easily
  • Oracle Cerner cloud migration requires coordination with Oracle’s managed services team, which adds external scheduling dependencies
  • OCI readiness validation includes network, identity, storage, and disaster recovery confirmation before any clinical workload moves
  • Reporting migration on Oracle Health uses different tooling than Epic, so Clarity-experienced analysts cannot transfer directly

Furthermore, Oracle Health’s implementation partner ecosystem is smaller than Epic’s. Hospitals should therefore confirm partner availability and certification status during vendor selection, not after contract signing.

3. Meditech Expanse Migration Timeline

Meditech Expanse migration timeline work is generally faster than Epic or Oracle Health for community hospitals because the platform is designed specifically for smaller facilities with less complex workflows. However, faster does not mean simple.

Key timeline factors for Meditech Expanse:

  • Module configuration for clinical, financial, and operational workflows requires Meditech-certified analysts with community hospital workflow experience
  • Interoperability configuration, including FHIR R4 APIs and HL7 interface migration, follows Meditech’s specific integration framework rather than a generic middleware approach
  • Community hospital workflows in Meditech Expanse often involve tightly coupled modules where one configuration change affects multiple departments simultaneously
  • Reporting and analytics migration requires building against Meditech’s native reporting environment before connecting to any external data warehouse

Meditech Expanse works well for hospitals that want a contained, vendor-managed path to cloud hosting. However, hospitals that need complex third-party integrations or custom analytics pipelines should plan for extended integration migration timelines beyond the standard Expanse deployment schedule.

4. Athenahealth Migration Timeline

Athenahealth migration timeline work differs from hospital EHR vendors because athenahealth is primarily an ambulatory and practice management platform. As a result, the migration profile looks different from an inpatient EHR project in several important ways.

Key timeline factors for athenahealth:

  • Ambulatory-heavy workflows require configuration at the practice and specialty level, not the hospital department level
  • Practice management and billing migration on athenahealth is deeply connected to the athenahealth network, which means claims routing, payer enrollment, and clearinghouse connections must be validated against athenahealth’s managed billing environment
  • Patient engagement migration timeline work, including patient portal, appointment reminders, and messaging, runs on athenahealth’s proprietary patient engagement layer and requires separate configuration and testing
  • Reporting and analytics rely on athenahealth’s managed reporting environment, which limits direct data warehouse integration compared to larger inpatient platforms

Because athenahealth manages more of the infrastructure directly, hospitals sometimes underestimate the configuration and workflow validation work that still sits on their side of the project.

5. Using KLAS Research For Vendor Validation

KLAS EHR implementation research is a useful buyer validation tool, but it should not serve as the primary source for timeline planning. Understanding the difference between the two uses matters before scoping begins.

What KLAS research is useful for:

  • Comparing vendor implementation satisfaction scores across health system sizes
  • Identifying common implementation failure patterns and post-go-live support gaps
  • Validating implementation partner performance before selecting a delivery firm
  • Benchmarking go-live timeline expectations against organizations of similar size and complexity

What KLAS research does not replace:

  • A vendor-specific discovery and assessment process for your organization’s actual systems
  • An interface inventory specific to your integration environment
  • A data quality assessment based on your actual patient records and legacy EHR structure

KLAS data reflects aggregated experience across many organizations. Your timeline, however, depends on your specific data, interfaces, workflows, and organizational readiness. Therefore, use KLAS to validate vendor and partner selection, then build the actual timeline from your own discovery findings.

When Does Cloud EHR Migration Start Showing ROI?

EHR migration ROI timeline results usually appear in stages. Infrastructure savings and reduced legacy system burden may show within 6 to 12 months, while workflow, reporting, interoperability, revenue cycle, and productivity gains often take 12 to 24 months. Hospitals should also expect a short productivity dip timeline during the EHR period directly after go-live before performance recovers.

ROI from cloud EHR migration does not arrive as a single event. Instead, it follows a sequence of stabilization, optimization, and legacy retirement. Therefore, boards and finance teams should evaluate value delivery in stages rather than expecting a single payback date.

1. Infrastructure And Legacy Cost Reduction

The earliest and most predictable ROI source is the reduction of legacy infrastructure costs. Because on-premises hardware, data center space, and hardware refresh cycles are replaced by cloud-managed infrastructure, hospitals begin seeing these savings within 6 to 12 months of go-live.

Specific cost reductions in this category include:

  • Data center operating costs, including power, cooling, and physical security
  • Hardware refresh cycles that no longer apply when cloud infrastructure replaces on-premises servers
  • Legacy operating system and database licensing fees for retired systems
  • Reduced IT staffing hours previously dedicated to physical infrastructure maintenance
  • Lower disaster recovery costs as cloud-based DR replaces secondary data center facilities

However, these savings only materialize fully after legacy systems are formally decommissioned. Hospitals that run cloud and on-premises environments in parallel for extended periods after go-live delay this ROI category. Therefore, the legacy retirement plan must be built into the project timeline, not treated as a post-migration decision.

2. Interoperability, Reporting, And Interface Savings

After infrastructure savings, the next ROI wave comes from reduced interface maintenance burden and improved reporting availability. Because modern cloud EHR environments use standardized integration layers, interface defect rates and manual support hours typically fall within 9 to 18 months.

What improves in this ROI category:

  • Interface defect rate decreases as standardized HL7 and FHIR connections replace point-to-point legacy feeds
  • Reporting latency improves as cloud-native data pipelines replace overnight batch processes
  • Dashboard availability increases when operational reports run on cloud infrastructure with defined uptime commitments
  • Analytics migration timeline outcomes improve as data warehouse feeds stabilize on cloud pipelines
  • Duplicate system costs fall as consolidated cloud architecture replaces redundant reporting tools

Furthermore, better interoperability directly supports population health migration timeline outcomes and quality reporting migration requirements. These improvements are real, but they require stable integrations and a functioning data warehouse before they can be measured accurately.

3. Revenue Cycle Stability After Go-Live

Revenue cycle stability is one of the most closely watched ROI areas because billing disruptions are immediately visible in the financial statements. For most hospitals, revenue cycle performance stabilizes within 3 to 9 months after go-live, provided that claims testing and CDM migration were completed correctly before cutover.

What revenue cycle ROI looks like in practice:

  • Claim hold rates return to baseline after billing team retraining and workflow adjustment
  • Denial rates stabilize as coding system migration and payer routing are validated through the new environment
  • Coding lag decreases as physicians complete documentation training and adopt new workflow patterns
  • Payment posting accuracy improves as clearinghouse connectivity and remittance processing are confirmed stable
  • Charge capture accuracy recovers as CDM migration timeline validation is completed and department charges are reconciled

Revenue cycle disruption post-go-live is normal and expected. However, organizations that completed thorough revenue cycle cutover validation before go-live recover significantly faster than those that skipped parallel run testing.

4. The Productivity Dip And Recovery Curve

Every EHR migration produces a productivity dip after go-live. Clinicians slow down because workflows have changed, screen layouts are different, and muscle memory built over years does not transfer immediately. This is not a sign of failure. It is a predictable pattern that every hospital should plan for explicitly.

What the productivity dip looks like in practice:

  • Physician documentation time increases by 20% to 40% in the first 4 to 8 weeks after go-live
  • Help desk ticket volume spikes in the first 2 to 4 weeks as users encounter workflow differences
  • At-the-elbow support needs are highest in the first 2 weeks and taper gradually through week six
  • Super user support becomes the primary stabilization layer after formal at-the-elbow support ends
  • Workflow optimization requests increase between weeks 4 and 12 as users identify friction points

The recovery curve EHR migration follows usually returns to baseline productivity between 60 and 120 days post-go-live.

Organizations that invest in super user training, command center staffing, and workflow optimization cycles recover faster than those that reduce support too early.

5. Why ROI Should Be Measured After Stabilization

Measuring ROI during the first weeks after go-live produces misleading results. Because productivity is temporarily lower and support costs are temporarily higher, early measurements make the migration appear less valuable than it is. Instead, ROI baselines should be set using pre-migration metrics and measured again after stabilization is confirmed complete.

The table below shows when each ROI category typically becomes measurable and what to track.

ROI Area Expected Timing What To Measure
Legacy infrastructure reduction 6 to 12 months Data center, hardware, support costs
Interface maintenance reduction 9 to 18 months Interface defect rate, support hours
Reporting improvement 6 to 18 months Dashboard availability, report latency
Revenue cycle stability 3 to 9 months after go-live Claim holds, denial rate, coding lag
Disaster recovery improvement Immediate after validation RTO, RPO, failover success
Workflow optimization 12 to 24 months Task time, ticket volume, user adoption

ROI does not arrive all at once. It follows stabilization, optimization, and legacy retirement in sequence. Therefore, the board case should show staged value delivery rather than one immediate payback number. The next section covers when custom cloud EHR migration engineering is not the right move.

Build Your Cloud EHR Migration Roadmap With Intellivon

Intellivon helps hospitals and health systems turn cloud EHR migration into a controlled infrastructure roadmap. The team supports discovery, architecture planning, data migration, integration development, HIPAA controls, UAT, training support, go-live planning, and stabilization so CIOs can set realistic timelines, budgets, and board expectations before development begins.

1. Start With A Migration Readiness Assessment

Before any workload moves, Intellivon reviews your current EHR architecture, legacy systems, data quality, interfaces, reporting flows, revenue cycle dependencies, and security controls. This gives your leadership team a practical view of what can move first, what needs cleanup, and what could delay the migration.

2. Plan The Timeline By Workstream

Intellivon breaks the migration into clear workstreams: discovery, cloud architecture, data conversion, HL7/FHIR integration, workflow configuration, compliance, testing, training, go-live, and stabilization. This helps hospitals avoid vague delivery promises and build a timeline that reflects clinical, technical, financial, and operational risk.

3. Build Reusable Integration Foundations

Cloud EHR migration should not create another set of fragile point-to-point connections. Intellivon designs reusable integration layers for HL7 v2, FHIR R4, CDA, X12, APIs, integration engines, analytics feeds, and downstream systems so future facility rollouts become easier to manage.

4. Keep HIPAA And Go-Live Risk Built Into Delivery

Intellivon embeds PHI security, encryption, access controls, audit logs, BAA requirements, downtime planning, UAT, and go-live support into the migration plan. This keeps compliance, clinical continuity, and operational readiness connected throughout the project.

Ready to scope your cloud EHR migration timeline?
Talk to Intellivon to map your EHR architecture, data migration plan, integration roadmap, compliance controls, rollout model, cost range, and stabilization plan before committing to a full migration build.

Migrate To Your New Cloud EHR Platform

Conclusion

The EHR cloud migration timeline is a clinical, technical, financial, and compliance roadmap, not just an infrastructure plan. Most hospitals should plan structured phases for assessment, architecture, data migration, integrations, testing, training, go-live, and stabilization. Single hospitals typically need 9–18 months, while large systems need 18–36 months.

With early planning, leaders can protect patient care, control risk, and secure board confidence without slowing modernization or creating avoidable disruption across departments.

Things To Know About EHR Cloud Migration Timeline

Q1. How long does cloud EHR migration take?

A1. Cloud EHR migration usually takes 9–18 months for one hospital and 18–36 months for a multi-facility health system. However, smaller clinics can move faster when data, interfaces, and workflows are simple. Hospitals need longer schedules because data migration, HL7/FHIR interfaces, UAT, training, go-live, and stabilization must align.

Q2. What is the EHR cloud migration timeline hospitals should present to the board?

A2. Hospitals should present a 12–18 month board timeline for one facility, split into 2–3 months for discovery, 2–4 months for architecture, 3–7 months for data and integrations, 2–4 months for testing and training, and 2–4 months for stabilization. Meanwhile, multi-hospital waves should appear as separate rollout plans.

Q3. How does the Epic cloud migration timeline differ from Oracle Health cloud migration timeline planning?

A3. Epic cloud migration timeline planning often centers on Bridges, Interconnect, MyChart, Clarity, Caboodle, reporting, downtime procedures, and Epic analyst capacity. However, Oracle Health planning may include Oracle Cerner cloud migration, OCI readiness, Millennium workflows, FHIR/API dependencies, and Oracle Health Foundation EHR sequencing. Therefore, each vendor needs its own timeline.

Q4. How should hospitals prevent EHR migration timeline overrun?

A4. Hospitals prevent timeline overrun by completing current-state assessment early, documenting interfaces, limiting historical data scope, assigning clinical owners, funding UAT, planning revenue cycle cutover, and validating reports before go-live. Additionally, the project plan should include a 10%–20% buffer for dependency delays, approval cycles, training gaps, and stabilization fixes.

To Sum Up:

  • A hospital’s EHR cloud migration timeline is usually controlled by data validation, clinical sign-off, revenue cycle cutover, and interface testing, not cloud provisioning speed.
  • Migrating every historical record into the active cloud EHR can increase cost, delay go-live, and reduce usability without improving care continuity.
  • Revenue cycle, reporting, and analytics cutover should be treated as core migration workstreams because broken dashboards and claims workflows can delay launch.
  • A phased migration timeline is safer for multi-hospital networks because every facility has different interfaces, workflows, data quality, and support needs.
  • The best cloud EHR migration budget separates discovery, architecture, data, integrations, compliance, testing, training, go-live, and stabilization instead of hiding them under one IT estimate.
